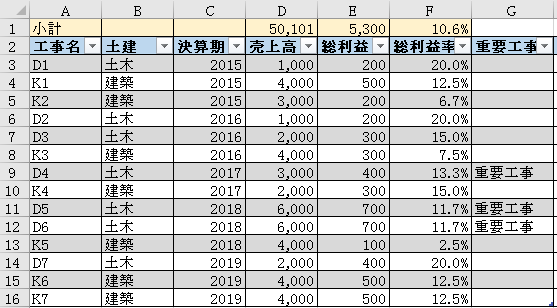

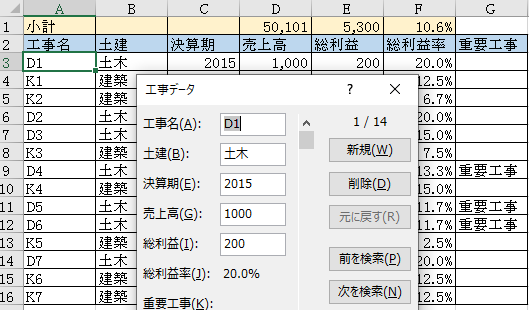

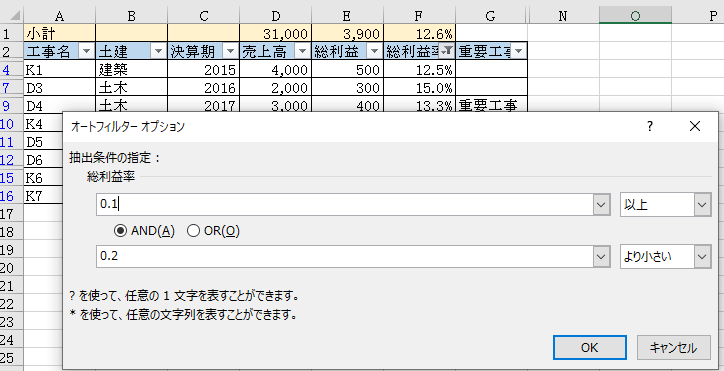

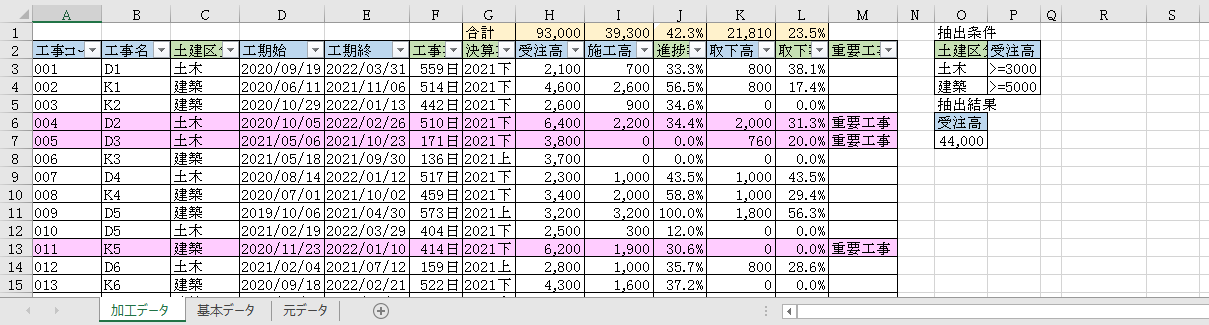

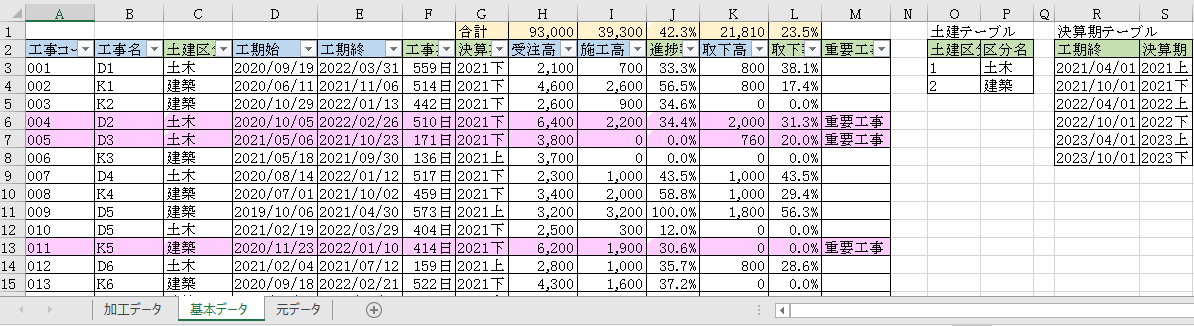

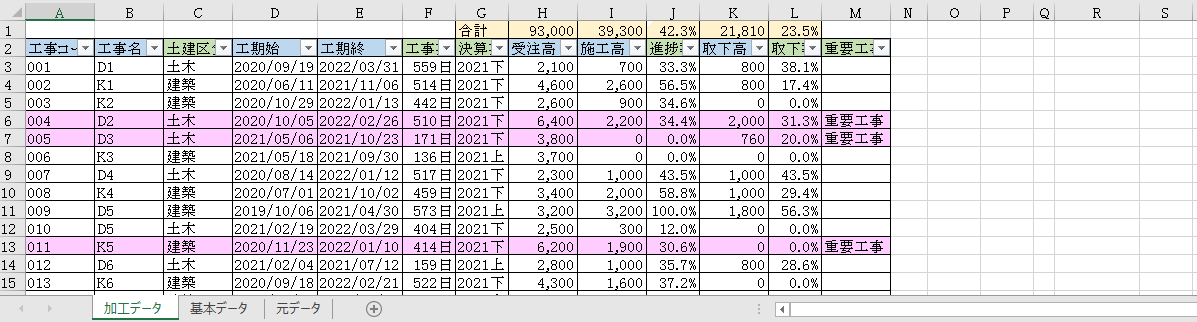

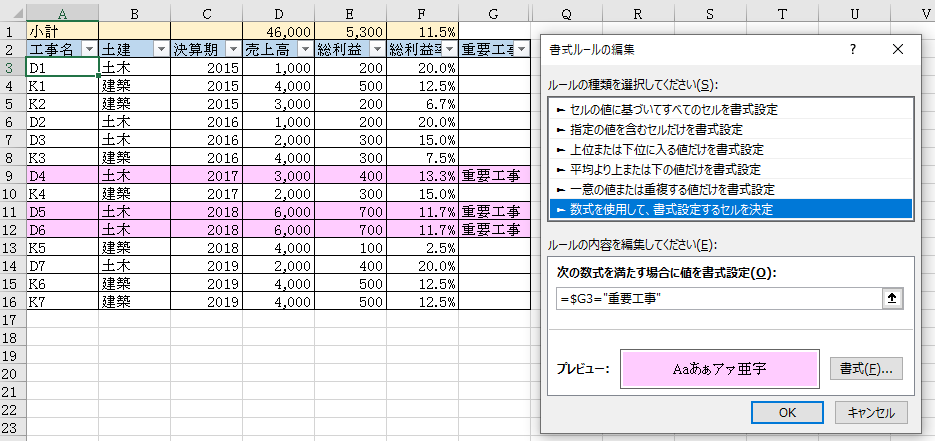

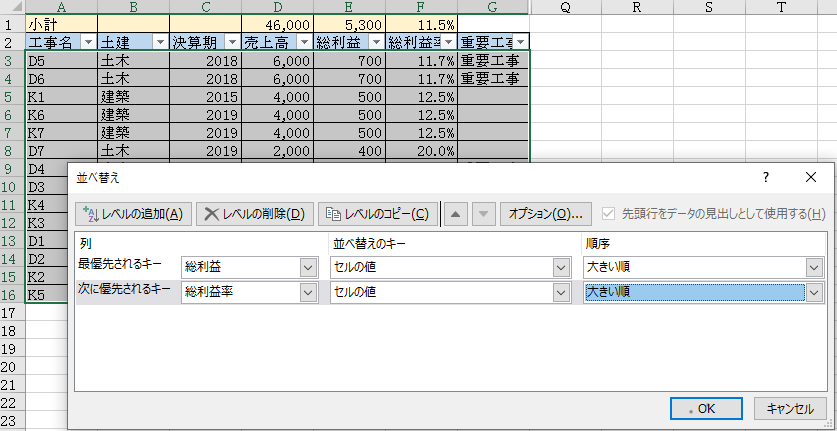

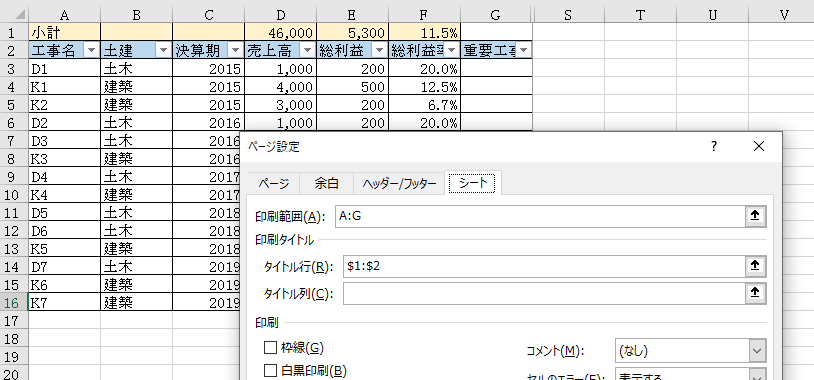

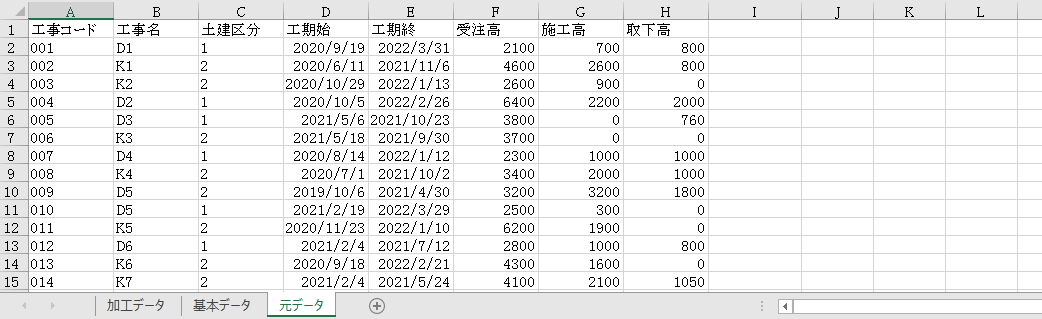

| (列)項目名 | 計算式 | 書式 |
| (B列)工事名* | =IF($A3="","",VLOOKUP($A3,元データ!$A:$H,MATCH(B$2,元データ!$1:$1,0),FALSE)) | |
| (C列)土建区分 | =IF($A3="","",VLOOKUP(VLOOKUP($A3,元データ!$A:$H,MATCH(C$2,元データ!$1:$1,0),FALSE),$O:$P,2,FALSE)) | |
| (D列)工期始* | =IF($A3="","",VLOOKUP($A3,元データ!$A:$H,MATCH(D$2,元データ!$1:$1,0),FALSE)) | yyyy/mm/dd |
| (E列)工期終* | =IF($A3="","",VLOOKUP($A3,元データ!$A:$H,MATCH(E$2,元データ!$1:$1,0),FALSE)) | yyyy/mm/dd |
| (F列)工事期間 | =IF($A3="","",DAYS(E3,D3)+1) | #,##0"日" |
| (G列)決算期 | =IF($A3="","",VLOOKUP(E3,$R:$S,2,TRUE)) | |
| (H列)受注高* | =IF($A3="","",VLOOKUP($A3,元データ!$A:$H,MATCH(H$2,元データ!$1:$1,0),FALSE)) | #,##0;[赤]-#,##0 |
| (I列)施工高* | =IF($A3="","",VLOOKUP($A3,元データ!$A:$H,MATCH(I$2,元データ!$1:$1,0),FALSE)) | #,##0;[赤]-#,##0 |
| (J列)進捗率 | =IF($A3="","",IF(H3=0,"",I3/H3)) | 0.0%;[赤]-0.0% |
| (K列)取下高* | =IF($A3="","",VLOOKUP($A3,元データ!$A:$H,MATCH(K$2,元データ!$1:$1,0),FALSE)) | #,##0;[赤]-#,##0 |
| (L列)取下率 | =IF($A3="","",IF(H3=0,"",K3/H3)) | 0.0%;[赤]-0.0% |
| (M列)重要工事 | =IF(C3="土木",IF(H3>=3000,"重要工事",""),IF(C3="建築",IF(H3>=5000,"重要工事",""),"")) | |
